Modeling

The ExpansionPlanningModel class implements a modular Generalized Disjunctive Programming (GDP) formulation to produce a generalized model for generation, transmission, and expansion planning (GTEP) for power infrastructure problems. This formulation is represented as a dispatch problem integrated within a unit commitment and an investment problem for a specified representative period. Each of these problems is considered a “stage” in this formulation and is defined using a Pyomo Block component.

Figure 1 shows a graphical representation of these stages, including the relevant model components (variables and constraints), and the terms that connect the stages in the formulation. Note in Figure 1 that the commitment stage serves as the primary link between the stages.

_images/model_stages.png

Figure 1. Modular representation of the three stages included in the GTEP model formulation.

In the following section, we provide a more detailed explanation of these stages and how they are defined in the model.

Model Formulation and Construction

To develop the GTEP model in Figure 1, we start by splitting the formulation into three key stages:

  1. Investment stage: Estimates relevant investment costs such as installation, expansion (which includes the installation of new selected generation units), operating costs, penalty, and maintenance costs. These costs include representative costs for both thermal and renewable generators as well as transmission equipment (e.g., transmission lines). Additionally, it declares a discrete decision (represented as a disjunction through the GDP formulation) to determine the operational state of the generation and transmission equipment (operational, retired, etc.) that can potentially influence the investment costs.

  2. Commitment stage: Determines the operational status of the generators (set as a disjunction) while considering relevant operational costs and constraints to ensure a reliable power generation service. Additionally, it establishes operating limits considering the availability of the equipment from the dispatch stage.

  3. Dispatch stage: Defines the status of transmission lines using a discrete decision (set as a disjunction) while considering operational costs, operability limits (such as power flow, ramping, reserves, etc.), and constraints to ensure the effective use of the active power lines.

Additionally, we include a data allocation step (prior to the formulation of the three stages) that assigns all relevant operating and cost parameters of the model. Since we are considering this as a data preprocessing step, not a stage in the formulation, this step is not represented in Figure 1.

Below we outline the steps we followed to construct the GTEP model. Note that the first four steps correspond directly to the stages described above (in some steps, the description is accompanied by example code).

Step 1: Data allocation

  1. The initial step to create this model is to import the necessary libraries.

    import json
    import numpy as np
    import math
    from math import ceil

    # Import Pyomo components
    from pyomo.environ import *
    from pyomo.environ import units as u
    from pyomo.common.timing import TicTocTimer
    from pyomo.repn.linear import LinearRepnVisitor

    from egret.data.model_data import ModelData
    from egret.model_library.transmission.tx_utils import scale_ModelData_to_pu
    from config_options import _get_model_config

    # Import IDAES-GTEP functions
    from gtep.gtep_model import model_data_references
    from gtep.gtep_model import model_create_investment_stages
    from gtep.gtep_model import create_objective_function

  2. Continue the creation of the GTEP model by including a new Python class, which includes a set of relevant parameters for the solution of the model, as arguments of the function.

    class ExpansionPlanningModel:
         """A generalized generation and
            transmission expansion planning model.
         """

         def __init__(
             self,
             config=None,
             stages=1,
             formulation=None,
             data=None,
             num_reps=3,
             len_reps=24,
             num_commit=24,
             num_dispatch=4,
         ):

             self.stages = stages
             self.formulation = formulation
             self.data = data
             self.num_reps = num_reps
             self.len_reps = len_reps
             self.num_commit = num_commit
             self.num_dispatch = num_dispatch
             self.config = _get_model_config()
             self.timer = TicTocTimer()

  3. Inside the ExpansionPlanningModel() class, we create a concrete Pyomo model object using the ConcreteModel component. Within this model, we define several time-dependent parameters for each stage, including:

    1. Number of Commitment and Dispatch Periods, which specifies the total number of periods allocated for the commitment and dispatch stages. These are key to determine the operational status of generators over time and how power flows are managed across the transmission network.

    2. Length of Commitment and Dispatch Periods, which defines the duration of each commitment and dispatch periods. These allow us to model the time intervals during which generators can change their status (on, off, etc.) and evaluate operational decisions made during the power dispatch stage.

    def create_model(self):
        """Create concrete Pyomo model object associated with the ExpansionPlanningModel"""

        self.timer.tic("Creating GTEP Model")
        m = ConcreteModel()

        if self.data is None:
            raise
        elif type(self.data) is list:
            m.data_list = self.data
            m.md = scale_ModelData_to_pu(self.data[0])

        model_set_declaration(
            m, self.stages,
            rep_per=[i for i in range(1, self.num_reps + 1)]
        )
        m.representativePeriodLength = Param(
            m.representativePeriods,
            within=PositiveReals,
            default=24,
            units=u.hr
        )
        m.numCommitmentPeriods = Param(
            m.representativePeriods,
            within=PositiveIntegers,
            default=2,
            initialize=self.num_commit,
        )
        m.numDispatchPeriods = Param(
            m.representativePeriods,
            within=PositiveIntegers,
            default=2,
            initialize=self.num_dispatch,
        )
        m.commitmentPeriodLength = Param(
            within=PositiveReals,
            default=1,
            units=u.hr
        )
        m.dispatchPeriodLength = Param(
            within=PositiveReals,
            default=15,
            units=u.min
        )

  4. Create and label data in the model using a data pre-processing function. This function ties the input data directly to the model by assigning values to all parameters. Look at the Data section for more information.

    model_data_references(m)

Step 2: Define Investment Stage

  1. We define the investment stage using a Pyomo Block component. This block includes all relevant cost variables and constraints associated with generation and transmission equipment including operating, expansion, maintenance, and penalty costs. Additionally, it incorporates a discrete decision using a Pyomo.GDP Disjunction component to define the operational status of generation and transmission equipment, while considering a series of linking constraints to monitor the operational, installed, and retired states of the equipment. Table 1 presents a list of these key components, including their definition.

    In the GTEP model, we include the pre-defined function below that incorporates all these components.

    model_create_investment_stages(m, self.stages)

    During the calculation of the operating costs in this stage, we establish a connection with the commitment and dispatch stages. For this, we define a second Pyomo Block component for the commitment stage. Figure 2 illustrates this interconnection and how these relationships propagate throughout the formulation.

    _images/model_investment_stage.png

    Figure 2. Modular representation of the investment stage.

    Table 1: Model components (parameters, variables, constraints, and disjunctions) in the investment stage

    Component

    Type

    Definition

    representativePeriods

    Set

    Representative periods for the investment stage

    commitmentPeriods

    Set

    Commitment periods in the investment stage

    dispatchPeriods

    Set

    Dispatch periods in the investment stage

    maxThermalInvestment

    Parameter

    Maximum investment for thermal generators

    maxRenewableInvestment

    Parameter

    Maximum investment for renewable generators

    renewableSurplusRepresentative

    Variable

    Minimum renewable generation requirement per stage

    renewableOperational

    Variable

    Power provided to the grid by renewable generator at operation

    renewableInstalled

    Variable

    Power provided to the grid by renewable generator at installation

    renewableRetired

    Variable

    Power removed from the grid if renewable generator is retired

    renewableExtended

    Variable

    Power provided to the grid if renewable generator lifetime is extended

    quotaDeficit

    Variable

    Deficit for investment stage

    expansionCost

    Variable

    Cost of investment for new installed generators and transmission lines

    renewableCurtailmentInvestment

    Variable

    Curtailment penalties for investment stage

    operatingCostInvestment

    Expression

    Operating cost for investment period

    investStatus

    Disjunction

    Discrete decision to determine the status for generation investment. The alternatives, expressed as disjuncts in the model are: genOperational, genInstalled, genRetired, genDisabled, and genExtended

    branchInvestStatus

    Disjunction

    Discrete decision to determine the status for the transmission equipment investment. The alternatives (as disjuncts) are: branchOPerational, branchInstalled, branchRetired, branchDisabled, and branchExtended

    gen_stats_link

    Constraint

    Propagate the thermal generators status considering their previous state

    renewable_stats_link

    Constraint

    Propagate the renewable generators status considering their previous state

    renewable_retirement

    Constraint

    Propagate the renewable generation retirement status based on previous state and lifetime of renewable equipment

    consistent_extended

    Logical constraint

    If a generator is extended at time t, it must stay extended or retired at time t

    consistent_branch_operation

    Logical constraint

    If a branch is online at time t, it must have been on or installed at time t-1

    consistent_branch_operation_future

    Logical constraint

    If a branch is online at time t, it must be on, extended, or retired at time t+1

    consistent_branch_extended

    Logical constraint

    If a branch is extended at time t-1, it must stay extended or be retired at time t

    consistent_operation

    Logical constraint

    If a generator is online at time t, it should be online or installed at time t-1

    consistent_operation_future

    Logical constraint

    If a generator is online at time t, it can be online, extended, or retired at time t+1

    consistent_branch_disabled

    Logical constraint

    If a branch is disabled at time t-1, it must stay disabled or be installed at time t

    full_retirement

    Logical constraint

    If a generator is retired at time t-1, it should be disable at time t

    full_investment

    Logical constraint

    Installation in period t-1 implies operational in period t

    full_branch_retirement

    Logical constraint

    Retirement in period t-1 implies disabled in period t

    full_branch_investment

    Logical constraint

    Installation in period t-1 implies operational in period t

Step 3: Define Commitment Stage

  1. Within the commitment block defined in step 2(a), we incorporate the commitment periods and introduce relevant components to ensure that the operation of transmission and generation equipment aligns with their designated statuses. During this stage, we also introduce cost and operational constraints that are contingent upon the commitment decisions and the outcomes of the dispatch stage. Table 2 provides a detailed overview of the components in the commitment stage of the model formulation.

    Figure 3 illustrates the various components utilized in this stage, highlighting the terms that connect to the dispatch stage.

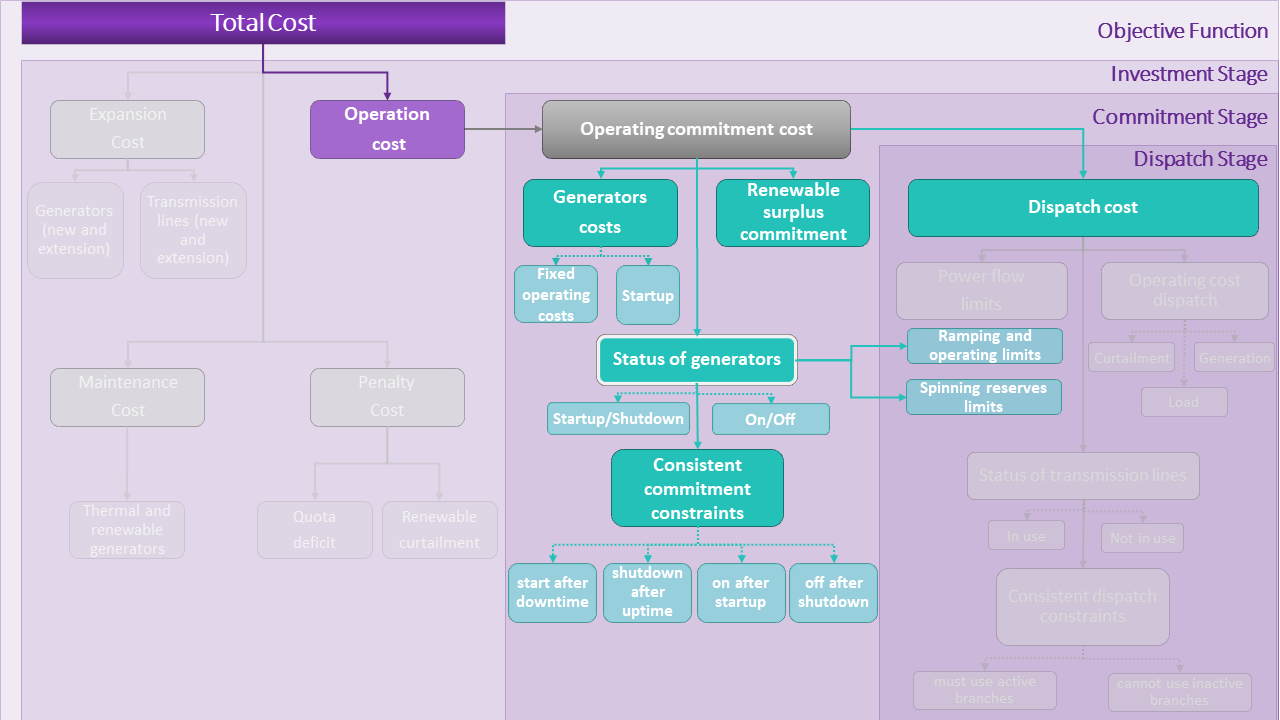

    _images/model_commitment_stage.png

    Figure 3. Modular representation of the commitment stage.

    Table 2: Components in the commitment stage

    Component

    Type

    Description

    dispatchPeriods

    Set

    Number of dispatch periods

    carbonTax

    Parameter

    Carbon tax

    renewableSurplusCommitment

    Expression

    Total renewable surplus/deficit for commitment

    operatingCostCommitment

    Expression

    Define total operating costs for commitment

    renewableCurtailmentCommitment

    Expression

    Define total curtailment for commitment

    genStatus

    Disjunction

    Discrete decision to set the status of the generation equipment. The alternatives, as disjuncts are: genOn, genStartup, genShutDown, and genOff.

    consistent_commitment_shutdown

    Logical constraint

    consistent_commitment_off_after_shutdown

    Logical constraint

    consistent_commitment_startup

    Logical constraint

    consistent_commitment_on_after_startup

    Logical Constraint

    consistent_commitment_uptime

    Logical Constraint

    consistent_commitment_shutdown_after_uptime

    Logical Constraint

    consistent_commitment_downtime

    Logical Constraint

    consistent_commitment_start_after_downtime

    Logical Constraint

    commit_active_gens_only

    Logical constraint

    Generators cannot be committed unless they are operational or just installed

Step 4: Define Dispatch Stage

  1. This stage incorporates all key variables and constraints associated with the dispatch problem, including operational limits for generation and curtailment, as well as definitions for load shedding and surplus dispatch. Additionally, this stage outlines the costs associated with these variables. Table 3 and Figure 4 provide a more detailed description of these components and their definitions in the formulation.

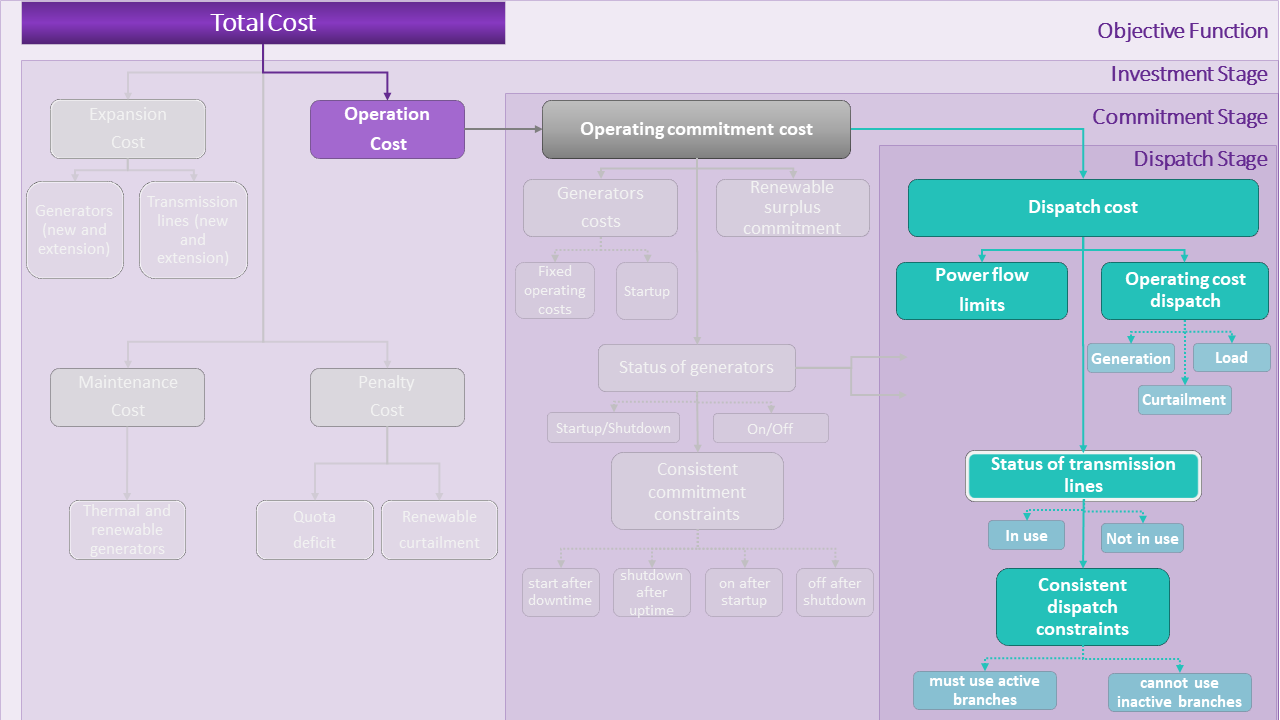

    _images/model_dispatch_stage.png

    Figure 4. Modular representation of the dispatch stage.

    Table 3: Components in dispatch stage

    Component

    Type

    Description

    thermalGeneration

    Variable

    Thermal generation power during the dispatch stage

    renewableGeneration

    Variable

    Renewable generation power during the dispatch stage

    renewableCurtailment

    Variable

    Amount of curtailed renewable power

    spinningReserve

    Variable

    quickstartReserve

    Variable

    powerFlow

    Variable

    Power flow

    renewableGenerationSurplus

    Expression

    Power surplus per renewable generator

    renewableCurtailmentCost

    Expression

    Cost of curtailment per renewable generator

    generatorCost

    Expression

    Thermal generator cost based on the fuel cost

    loadShedCost

    Expression

    Load shed cost per bus

    branchInUseStatus

    Disjunction

    Discrete decision to determine the status of the transmission equipment. The alternatives are: branchInUse (which includes the DC OPF equations) and branchNotInUse (which fixes power flow to zero).

    must_use_active_branches

    Logical constraint

    If a branch is in use, it must be active

    cannot_use_inactive_branches

    Logical constraint

    If a branch is not in use, it must be inactive

Step 5: Define objective function

Once the data and blocks for the different stages are incorporated, we define the total cost as the objective function using the Pyomo Objective component. The total cost includes not only investment costs, but also operating, expansion, and penalty costs that connect all the stages in the formulation. The objective function is integrated within the following pre-defined function.

create_objective_function(m)
class gtep.gtep_model.ExpansionPlanningModel(config=None, stages=1, formulation=None, data=None, cost_data=None, num_reps=3, len_reps=24, num_commit=24, num_dispatch=4, duration_dispatch=15)

A generalized generation and transmission expansion planning model.

create_model()

Create concrete Pyomo model object associated with the ExpansionPlanningModel

report_large_coefficients(outfile, magnitude_cutoff=100000.0)

Dump very large magnitude (>= 1e5) coefficients to a json file.

Outfile:

should accept filename or open file and write there; (see how we do this in pyomo elsewhere)

Magnitude_cutoff:

magnitude above which to report coefficients

report_model(outfile='pretty_model_output.txt')

Pretty prints Pyomo model to outfile.

Outfile:

(str, optional) _description_. Defaults to “pretty_model_output.txt”.

gtep.gtep_model.add_commitment_constraints(b, comm_per)

Add commitment-associated disjunctions and constraints to representative period block.

gtep.gtep_model.add_commitment_variables(b, commitment_period)

Add variables and disjuncts to commitment period block.

gtep.gtep_model.add_dispatch_constraints(b, disp_per)

Add dispatch-associated inequalities to representative period block.

gtep.gtep_model.add_dispatch_variables(b, dispatch_period)

Add dispatch-associated variables to representative period block.

gtep.gtep_model.add_investment_constraints(b, investment_stage)

Add standard inequalities (i.e., those not involving disjunctions) to investment stage block.

gtep.gtep_model.add_investment_variables(b, investment_stage)

Add variables to investment stage block.

Parameters:
  • b – Investment block

  • investment_stage – Investment stage index or name

Returns:

None

gtep.gtep_model.add_storage_constraints(m, b, commitment_period)

Battery Discharging Constraints

gtep.gtep_model.commitment_period_rule(b, commitment_period)

Create commitment period block.

Parameters:
  • b – commitment period block

  • commitment_period – corresponding commitment period label

gtep.gtep_model.create_objective_function(m)

Creates objective function. Total cost is operating cost plus expansion cost plus penalty cost (penalties include generation deficits, renewable quota deficits, and curtailment) :param m: Pyomo GTEP model.

gtep.gtep_model.investment_stage_rule(b, investment_stage)

Creates investment stage block.

B:

Investment block

Investment_stage:

ID for current investment stage

gtep.gtep_model.model_create_investment_stages(m, stages)

Creates investment blocks and linking constraints for GTEP model. Largely manages retirements and links operational units in a given investment stage to operational + installed - retired in the previous investment stage.

M:

Pyomo model object

Stages:

Number of investment stages in planning horizon

gtep.gtep_model.model_data_references(m)

Creates and labels data for GTEP model; ties input data to model directly. :param m: Pyomo model object

gtep.gtep_model.model_set_declaration(m, stages, rep_per=['a', 'b'], com_per=2, dis_per=2)

Creates Pyomo Sets necessary (convenient) for solving the GTEP model.

M:

Pyomo model object

Stages:

Number of stages in investment horizon

gtep.gtep_model.representative_period_rule(b, representative_period)

Create representative period block.

B:

Representative period block

Representative_period:

corresponding representative period label
